Skip to content

The capacity board

The planning board shows every member’s weeks ahead: what is planned, what is available and what has been tracked.

Capacity planning is off in a new workspace. An administrator switches it on under Settings → General → Modules → Capacity planning.

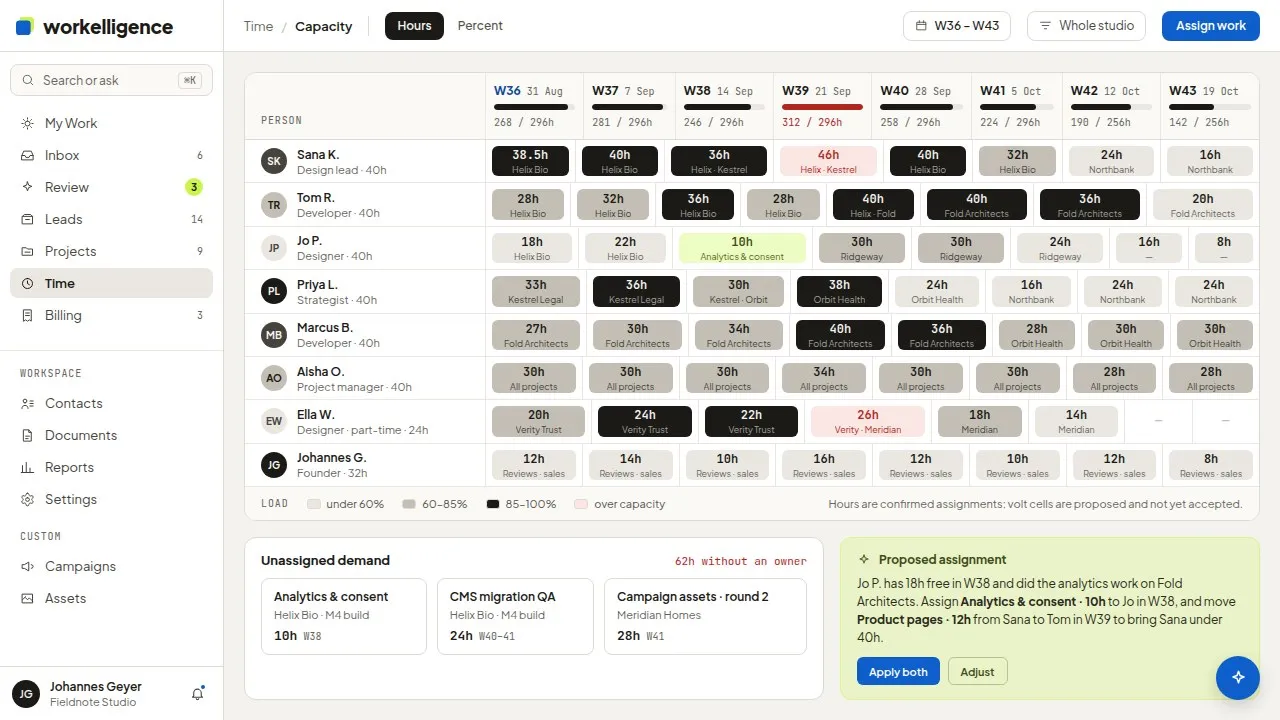

Open Time → Capacity. Each row is a person, each column a week.

FigureMeaning
TargetThe hours the person’s work schedule gives for that week, minus absences
PlannedHours of tasks planned into that week
AvailableTarget minus planned
TrackedHours already logged in that week

Each cell carries a band: free, planned, nearly full, overbooked or no availability. Use Earlier weeks and Later weeks to move, and This week to return.

Members without the planning permission see My plan, their own weeks only.

The Work that is not landing tray below the board lists open tasks with an estimate that are not planned into any week, or whose planned window is already past. Give them a planning window on the task, see The timeline.

Switch between hours and percent of the target. The percent view is the quickest way to spot the weeks over 100 %.
